TVC Tower

Project information

Project Deliverables
Architectural, Structural and MEP BIM models
MEP installation drawings
Services
BIM Modeling, BIM Coordination
Turnaround
200 days
Area
66000 Sq. M.
LOD
350

Responsibilities

From the given input drawings, Tesla had to create:

  • Architectural 3D model
  • Structural 3D model

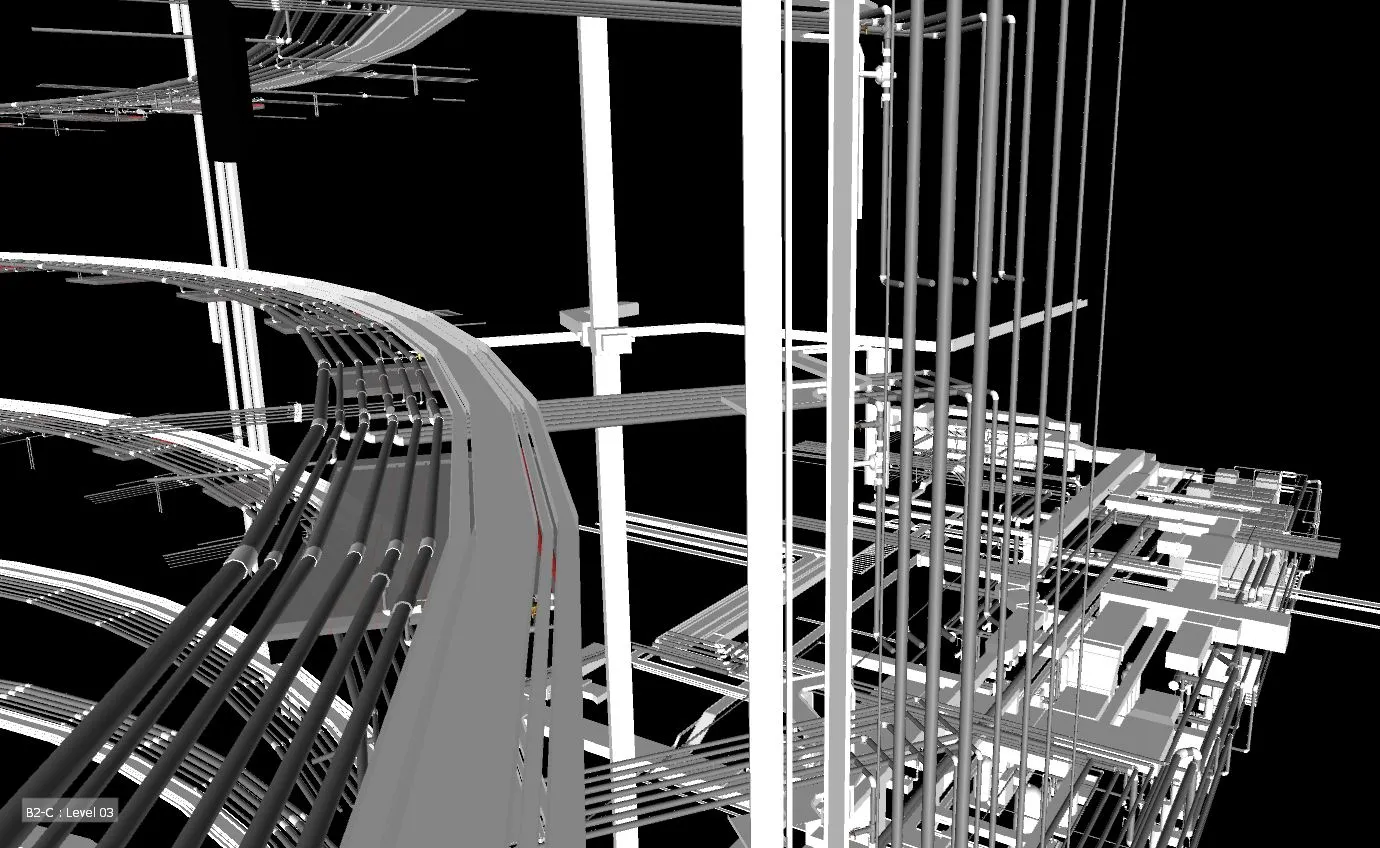

  • MEP 3D model
  • Coordination of different disciplines
  • MEP installation drawings

Challenges

Midway through the project, the deadline was preponed. From a quoted time of 300 days, the client requested the project to be completed in 200 days

There were several clashes in the models which required major changes in design

Solutions

The team size working on the project was increased and the resources were managed accordingly, with additional hours being put in to meet the deadline.

The design modifications were suggested by Tesla and were approved by our clients.
